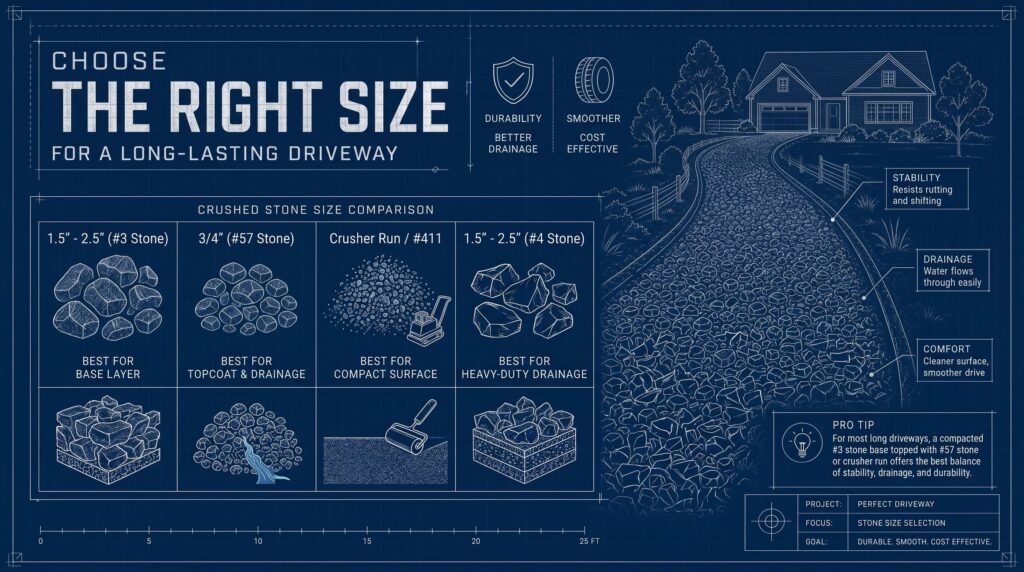

What Size Crushed Rock for Driveway: Which Crushed Stone Size Is Best for a Long Gravel Driveway?

Which Crushed Stone Size Is Best for a Long Gravel Driveway?

Table of Contents

Which crushed stone size is best for a long gravel driveway? In most cases, the best setup is a two-layer system: a compacted #3 stone base topped with #57 stone or crusher run. For homeowners, small contractors, landscapers, and other outdoor project planners in the U.S., that size combination is what gives a driveway the load support, drainage, and surface stability a long run needs.

A 200-foot gravel driveway is not simply a longer version of a 30-foot apron pad. A single-layer stone pour that holds up fine near the garage will rut, wash out, and scatter by the time you reach the road. Most long driveway failures trace back to two problems: using the wrong stone size for the job and skipping the layered build that makes a gravel surface hold up over years of use, which is why choosing the right rock size up front saves time and money on regrading and replacement.

The framework that works is a two-layer system: a compacted base that handles load and drainage, topped by a surface layer that takes daily tire contact. Below, you’ll see how to choose crushed stone sizes for each driveway layer, how traffic and climate affect that choice, how to estimate tonnage and cost, and how to install and maintain the surface so it stays in place. Before you pick the right stone, though, you need to know how much of each layer you’re actually dealing with. On a long driveway, the tonnage involved surprises almost everyone who hasn’t run the numbers first. Crushed Stone Calculator lets you estimate each layer separately so you have real quantities before you call a supplier, not an uncomfortable surprise after the first truck shows up.

Why a long driveway demands a layered stone system

The single-dump approach breaks down on longer runs for reasons that compound with distance. Load stress accumulates as tires travel the full length of the driveway repeatedly. Water channels along the grade rather than shedding quickly from a short surface. Tires track the same line over and over, concentrating wear in narrow bands instead of distributing it across a wider pad. Each of those forces becomes more damaging the longer the driveway runs.

A layered system works because each layer handles a different force. The base layer distributes load into the subgrade and moves water downward and away. A mid-layer or binder, where used, ties the coarse base to the finer surface. The topcoat takes tire contact, provides surface stability, and determines how the driveway looks and drives. On a long run, skipping the base and going straight to topcoat leaves no foundation to resist soft spots or seasonal heaving.

The failure pattern without a proper base is predictable. Tire ruts form first near the street end or at the gate, where traffic concentrates for turns and stops. Gravel migrates outward toward the edges rather than staying under tire paths. Washout channels form along the crown line after rain. That sequence is the reason to build the system correctly once rather than resurface repeatedly.

Which crushed stone size is best for a long gravel driveway, base vs. topcoat

The right driveway gravel size is actually two answers: one for the base and one for the surface, with each layer doing a distinct job. Getting both right is what separates a driveway that lasts a decade from one that needs attention every season. Here’s how the most common sizes stack up in each position, with common U.S. grading references generally following ASTM C33-style standards; for the surface, the usual recommendation for the main driveway material is about 3/4 inch to 1 inch.

The base layer: why #3 crushed stone earns its place

#3 crushed stone, which runs roughly 1½ inches to 2½ inches in size, belongs at the bottom because its angular shape creates interlock under compaction while still allowing water to drain downward rather than pool. Crushed rock is the generic name many people use for this kind of coarse aggregate, and crushed stone is produced by mechanically breaking down large rocks. Angular edges are what make this work. Using angular gravel in the bottom layer helps prevent shifting and creates a stable foundation. Rounded stone of the same size rolls under load instead of locking, which means it shifts instead of holds. For a residential driveway carrying passenger vehicles, plan on 4 to 6 inches of compacted #3 stone as the base within a typical 12 to 18 inch gravel driveway total. If the driveway handles heavier delivery trucks or farm equipment regularly, push that to 6 to 8 inches compacted. Limestone is a durable option and can work in both base layers and top layers when locally available. The right material here is a larger stone used as base material, not surface driveway stone, because it forms a solid base. To estimate this layer in the calculator, select #3 Stone (Coarse Base) at 1.30 tons/yd³ from the material dropdown.

The open gradation of #3 stone is also critical in freeze-thaw climates. An open base lets water drain away before it freezes and heaves the surface. In northern US states, that free-draining base layer does more useful work per dollar than any topcoat upgrade you can make.

The top layer: #57 stone, #411, and crusher run compared

#57 stone, a clean angular aggregate around 3/4 inch in size, sits in the most common sizes used for driveway surfacing, and that common target range is why #57 is such a standard top layer choice. It drains well, compacts to a stable driving surface, and resists displacement better than fine or rounded gravel. Choosing the right stone size matters here, and for most homeowners with passenger vehicle traffic, #57 on top of a compacted #3 base is the standard combination that holds up. #67 stone is smaller than #57 stone and is better suited to thinner surface layers.

#411 is a hybrid material that blends crushed stone with fines and stone dust. The primary difference from #57 is that the finer content packs tighter. It compacts tighter than #57 alone, which creates a firmer, less loose-feeling surface. It’s a good choice when you want a surface that feels more solid underfoot and under tire, particularly on long runs where a looser surface can feel inconsistent from end to end. Finer gravel helps reduce loose stones through tighter packing, but overused fines can lead to dust or mud issues. To estimate #411 quantities, select #411 Stone (Crushed + Fines) at 1.45 tons/yd³ in the calculator.

Crusher run, a mixture of crushed stone and rock dust from the full range of crusher output, is the right call when maximum compaction is the priority. At high-traffic points such as entries, sharp turns, and turnaround areas, crusher run on the surface locks down and resists the scattering that #57 can produce under repeated braking and turning. If the driveway carries trucks or equipment on a regular schedule, crusher run on the surface layer provides the stability to handle it. That makes the right gravel size and overall size gravel selection just as important as material type, while small gravel is better suited to a visible finish layer on shorter or lighter-duty surfaces. For more on using crusher run as a sturdy base and surface option, see the crusher run project base overview. #8 stone is generally reserved for concrete mixes and thin asphalt layers rather than typical long-driveway surface courses, and it can also be used near concrete when a compact, finer aggregate is needed.

How drainage, compaction, climate, and traffic shape your size decision

Drainage and freeze-thaw climates

In wet climates or regions with hard freeze-thaw cycles, open-graded stone in the base layer is non-negotiable. Fine-heavy materials like stone dust or dense-graded road base trap moisture. That trapped moisture freezes, expands, and lifts the surface, then thaws and leaves the base weaker and more susceptible to rutting. The cycle repeats every winter and accelerates base breakdown. Angular #3 or #57 stone in the base keeps voids open so water drains through rather than collecting where it can do structural damage. In areas with heavy rainfall or snow, angular crushed rock blended with stone dust is often used higher in the system to improve runoff control and surface knit while the base still provides excellent drainage.

The physical sequence of freeze-thaw damage matters here. Water enters the base, freezes and expands to create internal pressure, forms ice lenses that push the surface upward, then melts and leaves an unstable, saturated base just as vehicles apply load in spring. A free-draining base layer interrupts that cycle at the first step.

Traffic load and surface stability

Heavier or more frequent traffic pushes you toward tighter, well-graded mixes on the surface. #57 is the right call for typical passenger vehicle use on most residential driveways. When the driveway carries trucks, delivery vehicles, or farm equipment regularly, crusher run on the surface provides the stability needed without the surface scattering that coarser single-size stone produces.

One rule applies regardless of traffic level: angular stone in both layers outperforms pea gravel made of rounded stones. Pea gravel may look better and feel more comfortable underfoot, but it still rolls under load, migrates to edges, and remains a poor choice for a long, load-bearing driveway. The primary difference between rounded stones and angular gravel is interlock, which is why angular gravel helps prevent shifting under traffic. For a deeper explainer on crushed stone gradations and how different grades perform, consult an understanding crushed stone grades guide.

Estimating total tonnage for a multi-layer long driveway

Why long driveways surprise people with tonnage

Tonnage is consistently the most misjudged variable in long driveway projects, especially when quantities are estimated by eye rather than by the numbers. At a 4-inch base depth, 1,000 square feet of driveway needs roughly 12.35 cubic yards — about 16.1 tons using #3 Stone (1.30 tons/yd³), 17.3 tons using #57 Stone (1.40 tons/yd³), or 18.5 tons using Crusher Run (1.50 tons/yd³). A 300-foot driveway at 12 feet wide is 3,600 square feet. A 4-inch base layer for that area runs about 44.4 cubic yards — roughly 58 to 67 tons depending on your material. If you build a 6-inch base instead, that rises to about 66.7 cubic yards and approximately 100 tons at crusher run density.

The topcoat adds another 2 to 3 inches across the same area. A 4-inch base with topcoat totals approximately 89 to 105 tons for a driveway that size. A 6-inch base with topcoat pushes the total to 133 to 150 tons. Each layer is calculated separately, which is why totals add up faster than most people expect.

How Crushed Stone Calculator handles multi-layer estimates

Crushed Stone Calculator is built for exactly this kind of two-layer project. The process is straightforward: run one calculation for the base layer by entering width, length, and depth for the #3 stone, then run a second calculation for the topcoat using the same dimensions with your chosen depth. Select ‘#57 Stone (Clean Crushed)’ for a #57 surface layer, ‘#411 Stone (Crushed + Fines)’ for #411, or ‘Crusher Run / Road Base’ for crusher run.

The tool outputs cubic yards and estimated US tons for each layer separately, which is what you need to place two distinct material orders. For a quick online alternative, try an online crushed stone calculator, and for step-by-step quantity examples see How Much Crushed Stone for a Driveway: Layers and Cost.

On any long driveway with a grade change or irregular shape, apply a 15% waste factor rather than the default 10%. Irregular shapes, curved runs, and any slope with fill areas create material loss that a flat-footprint calculation won’t capture. A short-order situation mid-project on a 300-foot driveway is not a minor inconvenience, it’s a scheduling and cost problem that’s worth a few extra tons of buffer to avoid. Delivered prices for #57 stone run roughly $50 to $75 per ton in 2026, and crusher run typically runs $40 to $70 per ton delivered — confirm current pricing with your local supplier as prices vary by region, so knowing your quantities accurately before the first order saves real money.

Installation steps that make the layers actually hold

Choosing the right stone sizes and ordering the right quantities gets you to the job site ready. Installation technique determines whether those materials perform for years or start failing in the first season. For a complete layer-by-layer walkthrough and practical installation tips, consult the Gravel Driveway Installation Guide: DIY Layers, Depth & Cost.

Compact in lifts, not one thick dump

No lift thicker than 3 to 4 inches before compaction. This is the core principle behind every successful base installation. Spreading the full base depth at once and then running a plate compactor over the surface creates a firm crust over a loose, unstable layer underneath, the compactor doesn’t reach deep enough to consolidate material below the top few inches. Each lift needs to be lightly wetted, not saturated, then hit with multiple compactor passes in crossing directions before the next lift goes down. If you are building over soil or upgrading an existing driveway, landscape fabric can go below the gravel to help with weed control and separation. Layering different gravel sizes can improve compaction better than dumping one uniform thick layer. Moisture helps the fines lock and the angular faces seat against each other.

On a long driveway, this process takes more time than most homeowners budget for. A 300-foot base at 6 inches compacted means two 3-inch lifts across the entire run, with each lift fully compacted before the next goes down. Plan the schedule and equipment rental around that reality, not around the idea that gravel is just spread and driven on.

Crown, slope, and edge containment

Build a slight center rise, called a crown, so water sheds to both sides of the driveway rather than running down the middle. The same grading and drainage principles apply when rebuilding an existing driveway, not just installing a new one. Where runoff has to be redirected or slopes need support, culverts, french drains, or retaining walls may also be needed for proper drainage. Sloped driveways especially benefit from tightly compacting materials such as crusher run because they resist shifting and washout better on grades. On a long driveway, this is one of the highest-value structural decisions you can make from the start. Even a modest grade without a crown will direct water down the centerline, eroding the surface layer, cutting channels, and eventually working into the base. Build the crown into the compacted base layer so every subsequent lift follows the same profile.

Edge containment is equally important and often overlooked. Without a berm, edging, or defined shoulder, gravel migrates outward over time, particularly at curves where lateral tire force pushes material off the surface. A well-defined edge keeps the stone where the tires are and reduces how quickly the surface thins out between replenishments, while also helping with erosion control by limiting washout at the shoulders.

Maintenance that protects the investment over time

A well-built layered driveway can last about 10 to 20 years with consistent upkeep, and while it is not maintenance-free, it stays low-maintenance in a predictable way that protects its structural integrity. Knowing what to watch for makes the upkeep manageable rather than reactive.

When to replenish the topcoat

Most residential #57 or crusher run topcoats, used as the surface gravel layer, need replenishment every 5 to 7 years under typical passenger vehicle traffic with basic maintenance. Driveways that regularly carry trucks, delivery vehicles, or heavy equipment may need attention every 2 to 3 years. The signal is visible base stone showing through the surface layer. At that point, vehicles are beginning to contact the base directly rather than riding on the topcoat, which breaks down the base structure faster than surface wear alone. Replenishing before the base is exposed keeps the layered system intact and extends the intervals between any base repairs.

Spot repairs and regrading

Fill ruts early, before water channels into them and widens the damage. A rut that’s an inch deep is a simple fill-and-compact job, and early repairs on a stable base help avoid frequent maintenance. A rut that’s collected water for two seasons is a base repair. An annual pass with a box blade, landscape rake, or gravel rake to restore the crown and redistribute material adds only a few hours of work and keeps the surface profile doing its drainage job. A well-compacted base reduces how often the surface needs regrading because there’s a stable platform underneath that resists deformation rather than following it, while the wrong gravel choice leads to constant maintenance as the surface deforms more easily. Routine weed control also helps preserve the driveway surface and keeps regrading work manageable.

Getting the sizing and the system right from the start

To answer which crushed stone size is best for a long gravel driveway: use #3 for the base and #57 or crusher run for the surface, and treat them as a system, not separate decisions. A #3 crushed stone base gives you load distribution and drainage. A #57 or #411 topcoat gives you a driveable, stable surface that holds up across the full length of the run. Color and texture of crushed stone vary depending on the local quarry, which can change the finished attractive look and overall aesthetic appeal. For high-traffic points or driveways that carry heavier vehicles, crusher run on top delivers the compaction and surface stability that single-size stone can’t match. For additional tips on selecting and buying materials, review a guide to buying crushed stone and gravel.

The longer the driveway, the more each part of that system matters. Skipping the base, using rounded stone, or going with a single layer may look simpler, but choosing the right material affects appearance as much as long-term performance and saves far more than it costs upfront in repairs and resurfacing within a few years. Before you place any material order, run your numbers through Crushed Stone Calculator for both layers separately. Enter your actual dimensions, set a 15% waste factor for any driveway with curves or grade changes, and get the cubic yards and tonnage for each layer before you call a quarry or landscape supplier. For further comparisons of material types and costs, see Best gravel for driveways: Types, Layers, and Costs Guide.

Getting the best crushed stone size for your long driveway right, and knowing your quantities before the first delivery arrives, is the difference between a driveway that holds for a decade and one that needs attention before it ever fully settles.
